In Greater Vancouver’s competitive restaurant market, the speed at which you build out and open your commercial kitchen directly dictates your bottom line. Every day your project is stalled in the permitting or inspection phase translates into costly carrying charges and lost revenue. Building a commercial kitchen in this region requires a thorough understanding of localized building codes, trade synchronization, and stringent municipal bylaws. Drawing on Y&Y Construction’s extensive commercial tenant improvement experience across the Lower Mainland, we have structured this guide to help you successfully deliver a code-compliant, high-efficiency restaurant kitchen.
1. Navigating Municipal Permits: The Unique VBBL Framework
A common pitfall for new restaurateurs is assuming that provincial building codes apply uniformly across the region. In the City of Vancouver, construction must strictly adhere to the Vancouver Building By-law (VBBL), which enforces standards that are often more rigorous than the BC Building Code. Before broken ground, your project must secure three distinct layers of approval:
Development and Building Permits (DP & BP)
If you are transforming a former retail or office unit into a food-service establishment, a Development Permit for a "Change of Use" is typically required first. Following DP approval, a comprehensive Building Permit must be issued to authorize structural alterations and interior fit-outs.
Certified Trades Permits
Modifications to commercial plumbing networks, natural gas lines, and high-voltage electrical panels cannot be done under a general permit. Licensed sub-contractors must independently pull dedicated Plumbing and Electrical permits from the city.
Mechanical and Fire System Synchronization (NFPA 96)
Air balancing is heavily scrutinized by city inspectors. Your engineered mechanical drawings must demonstrate a precise equilibrium between your exhaust airflow and your Make-Up Air (MUA) system. Furthermore, under NFPA 96 standards, the wet-chemical nozzles of your automated fire suppression system must align perfectly with your specific cooking line (fryers, charbroilers, ranges). Consequently, your kitchen equipment layout must be completely finalized and locked in prior to submitting drawings to the fire department.
2. Fats, Oils, and Grease (FOG) Management: Metro Vancouver Regulations

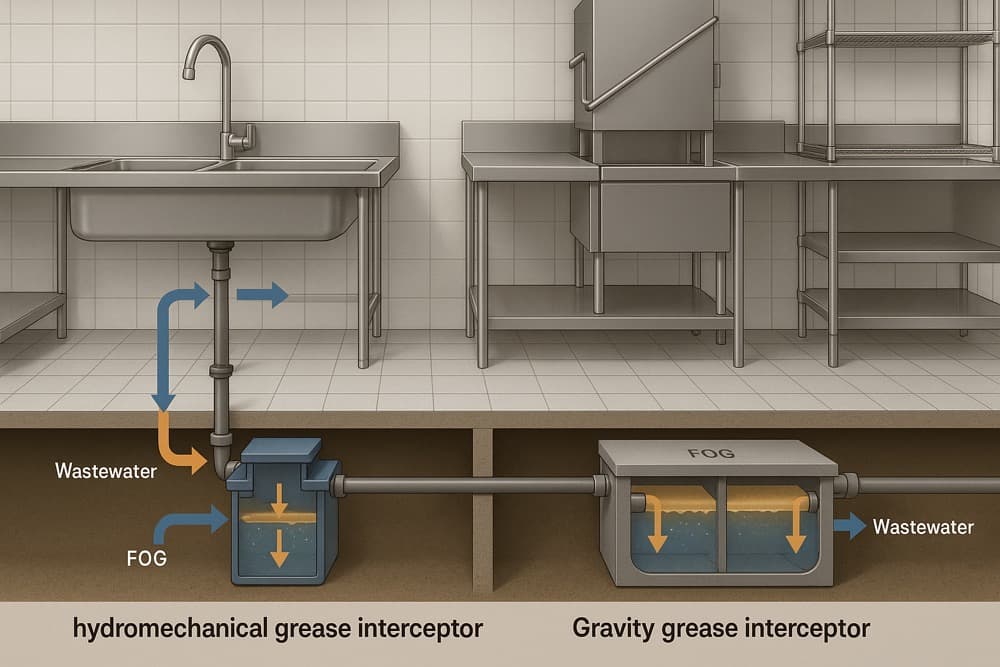

Environmental enforcement in the Lower Mainland is among the strictest in North America. Under the Metro Vancouver Sewerage Regulation Bylaw, discharging grease-laden wastewater into municipal infrastructure carries severe penalties. Implementing a compliant grease interceptor strategy is non-negotiable.
Engineered Sizing Specifications
Grease trap capacities cannot be estimated. A plumbing engineer must calculate the precise flow requirements based on the total "Fixture Units" of your commercial dishwashers, pre-rinse sinks, and floor drains to guarantee adequate retention time.
Overcoming Spatial Constraints
Many premier commercial spaces in Downtown Vancouver, Gastown, or multi-level retail podiums lack the structural real estate required for a traditional, exterior in-ground grease interceptor. To bypass these architectural limitations, Y&Y Construction works closely with mechanical engineers to source and approve compact, Automatic Grease Removal Devices (AGRDs) that fit directly beneath indoor dishwashing stations.
Mandatory Maintenance Logs
Once operational, grease interceptors must be pumped out systematically (typically before grease and solids reach 25% of the tank's capacity). By law, you must maintain a physical maintenance log on-site for a minimum of 24 months. Metro Vancouver environmental officers conduct unannounced inspections, and missing records or poorly maintained traps result in immediate municipal fines.
3. Commercial Ventilation and Kitchen Fire Safety Requirements
A robust commercial kitchen ventilation system does more than clear smoke—it ensures structural safety, odor control, and workplace comfort. Your HVAC and safety systems must achieve compliance across three key metrics:
Type I Hoods and Dedicated Make-Up Air
Any appliance that generates grease-laden vapors or high thermal loads requires a heavy-gauge Type I hood. To prevent building negative pressure—which causes backdrafts, freezing indoor temperatures, and heavy commercial doors that are difficult to open—your ventilation must be paired with a dedicated, heated Make-Up Air unit.
Fire-Rated Exhaust Ductwork
Kitchen exhaust ducts must be constructed from continuously welded, liquid-tight steel and enclosed within a certified fire-rated shaft or specialized fire wrap. Additionally, the ductwork must feature code-compliant access panels at every change of direction to facilitate routine professional cleanings.
Emergency Interlock Systems
Your mechanical and electrical systems must be fully integrated. In the event of a fire, the activation of the suppression system must instantly trigger an automatic utility shut-off, cutting gas and electricity to the cooking line. Concurrently, the supply air fans must shut down to avoid feeding oxygen to the flame, while the exhaust fans remain operational to draw toxic smoke out of the building.
4. Workflow Zoning and Health Authority Compliance
Depending on your municipality, your layout must be vetted and approved by either Vancouver Coastal Health (VCH) or Fraser Health before an operating license can be issued. To satisfy health inspectors and maximize labor efficiency, your floor plan should incorporate the following zoning principles:
Linear "One-Way" Workflow
To eliminate the risk of cross-contamination, the kitchen floor plan should follow a logical sequence: Receiving $\rightarrow$ Cold/Dry Storage $\rightarrow$ Food Prep $\rightarrow$ Cooking Line $\rightarrow$ Plating and Expo. This production line must never intersect with the return path of dirty dishes heading toward the dishwashing station.
Three-Stream Waste Integration
To comply with Metro Vancouver’s strict waste diversion mandates, your primary prep and dishwashing stations must feature dedicated, built-in real estate for landfill waste, recyclables, and organic compost. Neglecting to allocate distinct structural space for these three separation streams can lead to health inspection delays.
Infrastructure Future-Proofing
Given the exceptionally high cost of commercial renovations in Vancouver, it is highly recommended to build a 15% to 20% capacity buffer into your main electrical panel and mechanical duct sizes during the initial build. This allows your restaurant to pivot its menu or upgrade to heavier cooking appliances in the future without triggering another expensive and time-consuming municipal permit cycle.
5. Hidden Construction Pitfalls in Vancouver Projects
Concrete Core Drilling Risk
A significant portion of Vancouver’s prime commercial spaces occupy the ground floor of multi-story concrete high-rises. Coring through these slabs for drainage or exhaust lines requires mandatory X-ray scanning and structural engineering sign-offs. Striking an underground post-tension cable or primary rebar is a catastrophic error that results in structural damage and severe legal liabilities.
Strata Bylaws and Exhaust Setbacks:
If your commercial exhaust duct needs to route vertically along the exterior facade of a multi-unit building to reach the roof, securing municipal approval is only half the battle. You must obtain formal authorization from the building’s Strata Council. Property line setbacks, aesthetic guidelines, and structural noise/odor impacts on residential tenants above must be addressed early in the lease stage to prevent mid-construction injunctions.
Engage Health Officials Early
Experienced operators never wait until construction wraps up to schedule a health inspection. Submitting your kitchen equipment specification sheets and detailed spatial layouts to VCH or Fraser Health for pre-screening during the early design phase ensures that your physical build-out complies with sanitation codes on day one, clearing the path for a seamless grand opening.
FAQ
How long does a commercial kitchen renovation take in Vancouver?
On average, a standard commercial kitchen build-out or restaurant tenant improvement (TI) in Greater Vancouver takes between 8 to 16 weeks for the construction phase. However, the overall timeline heavily depends on the city's permit approval process (such as Development Permits and Building Permits under Vancouver's VBBL). At Y&Y Construction, we fast-track projects by conducting trade coordination and pre-screening layouts with health authorities during the early design phase to minimize delays.
What is the difference between a Type I and Type II kitchen hood under the Vancouver Building By-law (VBBL)?
The core difference lies in grease management and fire safety. A Type I Hood is mandatory for appliances that produce grease-laden vapors (e.g., commercial fryers, charbroilers, Chinese woks) and must be integrated with an NFPA 96-compliant automated fire suppression system. A Type II Hood is only designed to capture heat, steam, and odors from grease-free equipment like commercial dishwashers or steamers. Y&Y Construction ensures your mechanical ventilation layout perfectly matches your menu requirements for municipal inspection.
Do I need a new grease interceptor if I lease an existing restaurant space?
Not always, but it is highly likely if you alter the kitchen layout or menu. Under the Metro Vancouver Sewerage Regulation Bylaw, if your new menu increases the total "Fixture Units" (water flow from sinks/dishwashers), or if the existing grease trap fails random municipal inspections, you must upgrade it. For tight commercial spaces in Downtown Vancouver or Gastown, Y&Y Construction works with mechanical engineers to retrofit compact, indoor Automatic Grease Removal Devices (AGRDs) to ensure full compliance.
Why choose Y&Y Construction for my restaurant construction and TI in Greater Vancouver?
Y&Y Construction is a premier commercial general contractor specializing in restaurant fit-outs and retail renovations across the Lower Mainland. We bring seamless trade synchronization, comprehensive knowledge of localized municipal codes, and deep industry resources to every build. From structural engineering and concrete core drilling to final mechanical and fire safety handovers, we deliver your commercial kitchen on time, on budget, and fully compliant.
